Cooling tower Legionella testing: what a building owner needs
Cooling towers are treated as a separate system in every program, and in some jurisdictions they carry registration, treatment and testing requirements of their own. If your building has one, it is usually the first thing an authority will ask about.
Why towers are handled separately
A cooling tower is an open circuit: warm water is deliberately exposed to air to shed heat, which means aerosol is produced by design rather than by accident, and released outside the building where it is carried by wind.
That combination, warm water, aerosol, outdoor dispersion, is why towers attract specific attention, specific treatment regimes and, in some places, specific law.

Registration and specific rules
Some jurisdictions require cooling towers to be registered, maintained under a written plan, tested on a defined schedule, and reported on. Others have no tower-specific rule at all. The variation between states and cities on this single point is larger than on almost anything else in this subject.
The practical step: ask your local authority whether tower requirements apply at your address, and get the answer in writing. It is a short call and it changes the entire scope. The other places a requirement can come from are in where testing requirements come from.
Treatment, and what testing verifies
Towers are almost always under a water treatment program managed by a specialist contractor: biocide, scale and corrosion control, bleed and makeup, plus routine mechanical maintenance and cleaning.
Testing verifies that this program is achieving what it is meant to achieve. That framing matters commercially: if the same contractor both runs the treatment and reports the verification, ask how independence is handled. It is not an accusation, it is a normal governance question with a normal answer.
- Who maintains the treatment, and what is recorded.
- Who takes verification samples, and whether that is the same party.
- What the response plan says, and who authorizes remedial action such as an emergency clean.

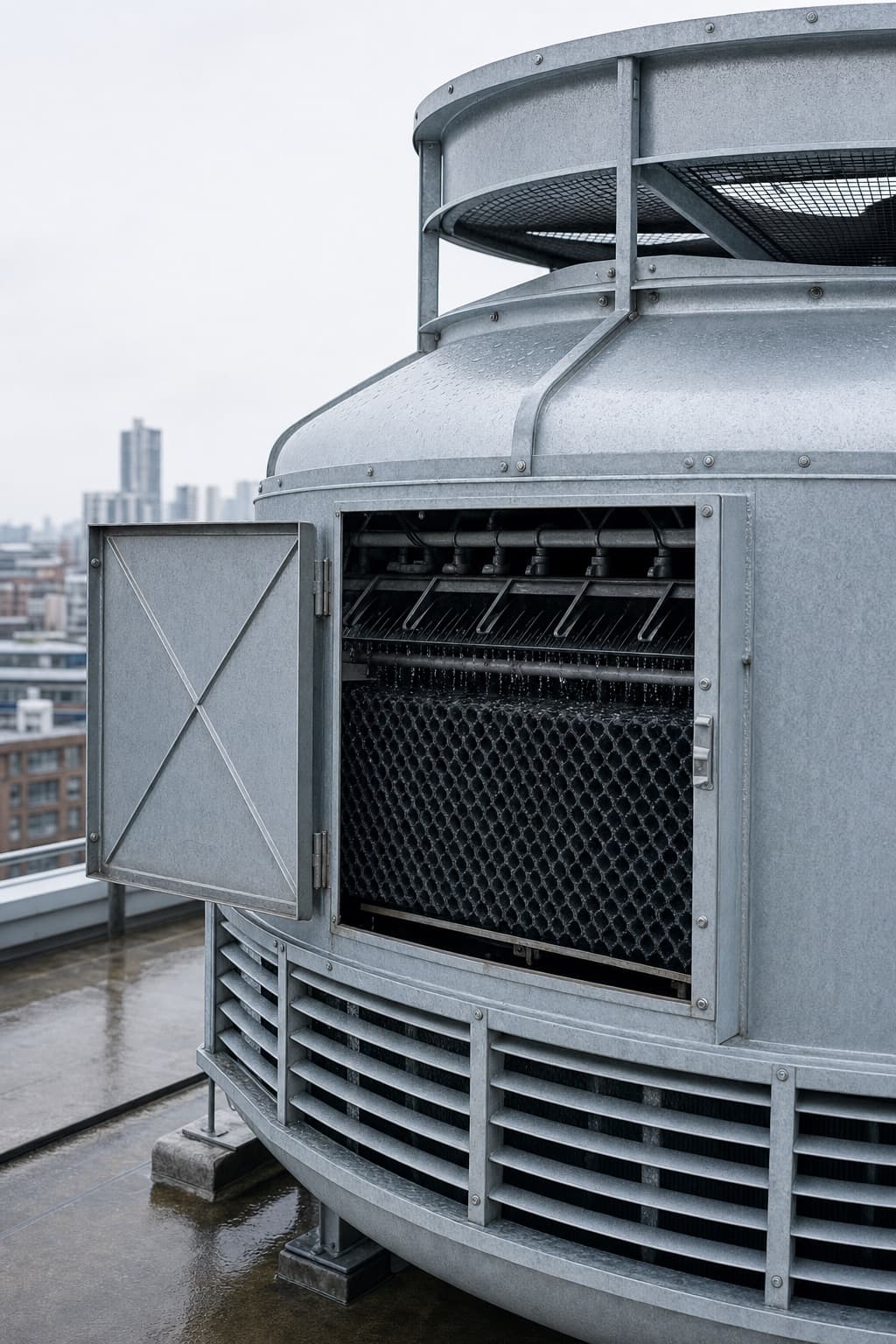

- Where the drift eliminator and mechanical condition sit in the inspection routine.
Cooling tower Legionella testing: the three layers a building owner needs
Owners are often told a tower is “being tested” when what is happening is one of three different things. A sound program has all three, and knows which party does each.
1. Process control, by the treatment contractor
Biocide residual, pH, conductivity, bleed and makeup, logged on a routine. None of these is a Legionella test. They show whether the conditions the program relies on are being held, and they are the first records anyone asks for after a problem.
2. A general microbial indicator
A heterotrophic plate count or dip slides, taken between Legionella samples. They do not identify Legionella; they show early that biological control is slipping, while there is still time to act.
3. Legionella culture by a laboratory
The verification: a sample of the bulk water, cultured by a laboratory, on the schedule your plan or a local rule sets. The laboratory should be able to show current proficiency for Legionella culture; enrolled laboratories are listed on the Legionella testing labs page.
On top of the routine, event-driven samples: after a seasonal restart, after a clean, after a loss of treatment, after an out-of-limit result, and whenever a health authority asks.
Where and how a tower sample is taken
- From water that represents the circuit, usually the basin or the return line, away from the points where makeup water and biocide enter.
- From the same point every time, so that one result can be compared with the last.
- In a laboratory bottle containing the neutralizer that treated water needs, otherwise the biocide keeps working in transit and the count reads low.
- With the time of the last biocide dose recorded. A sample drawn just after a dose describes the dose, not the routine.
If the treatment contractor takes the verification samples, these points are worth seeing written in their procedure. It is the simplest way to check that the result means what the report says.
What happens after a positive result
The response is decided before the result arrives, not after. A tower plan names who is told, which records are reviewed first (treatment logs, recent dosing, any loss of bleed or circulation), what corrective action follows, such as online disinfection or a clean, and when the verification sample is taken afterwards. Where a local rule applies, it may also say who must be notified and by when. How a clean changes the next result is covered in what a cleaning changes in a result.
Seasonal operation
A tower shut down for winter and restarted in spring is one of the standard high-attention moments: stagnant water in a system designed to circulate, followed by a return to full operation.
Startup and shutdown procedures, cleaning and verification around those events are normally written into the plan. Where they are not, the plan is describing a tower that runs all year, which yours may not.
Frequently asked
Do we have to register our cooling tower?
In some jurisdictions yes, in others there is no such requirement. It is a local question with a definite answer: your local health department or code official can tell you whether your tower has to be registered.
Is Legionella testing of a cooling tower a legal requirement?
It depends on where the tower is. Some states and cities require registration, a written plan and Legionella sampling on a set schedule; many have no tower-specific rule. Where no rule applies, a water management program following ASHRAE 188 still treats the tower as a separate system with its own verification.
Our treatment contractor says testing is unnecessary.
That may be a defensible technical position, and it is also a position taken by the party whose work testing would verify. Where a requirement applies, it is not theirs to waive.
How often should towers be sampled?
According to the plan and any applicable local requirement, which for towers is more often prescribed than for domestic water systems. No frequency is published here.
